Temporary Works Design

Propping, excavation support, formwork and crane bases designed for contractors, independently checked and certified on the .

Temporary works hold up the permanent works before they can hold up themselves, so they are designed against them: what the slab below can carry on the day it is loaded, where the frame is stable and where it is not yet, and what changes when the sequence does.

Under the Construction Regulations 2013 a temporary works designer is a designer, with the same duty to tell the and the in writing what the design depends on. We take that appointment from main contractors, specialist subcontractors and equipment suppliers across Ireland, as chartered engineers with professional indemnity behind the signature.

The same office designs permanent frames, precast included, so the props, the pour sequence and the erection stability are checked against the structure they are holding up rather than against an assumed one.

What we design

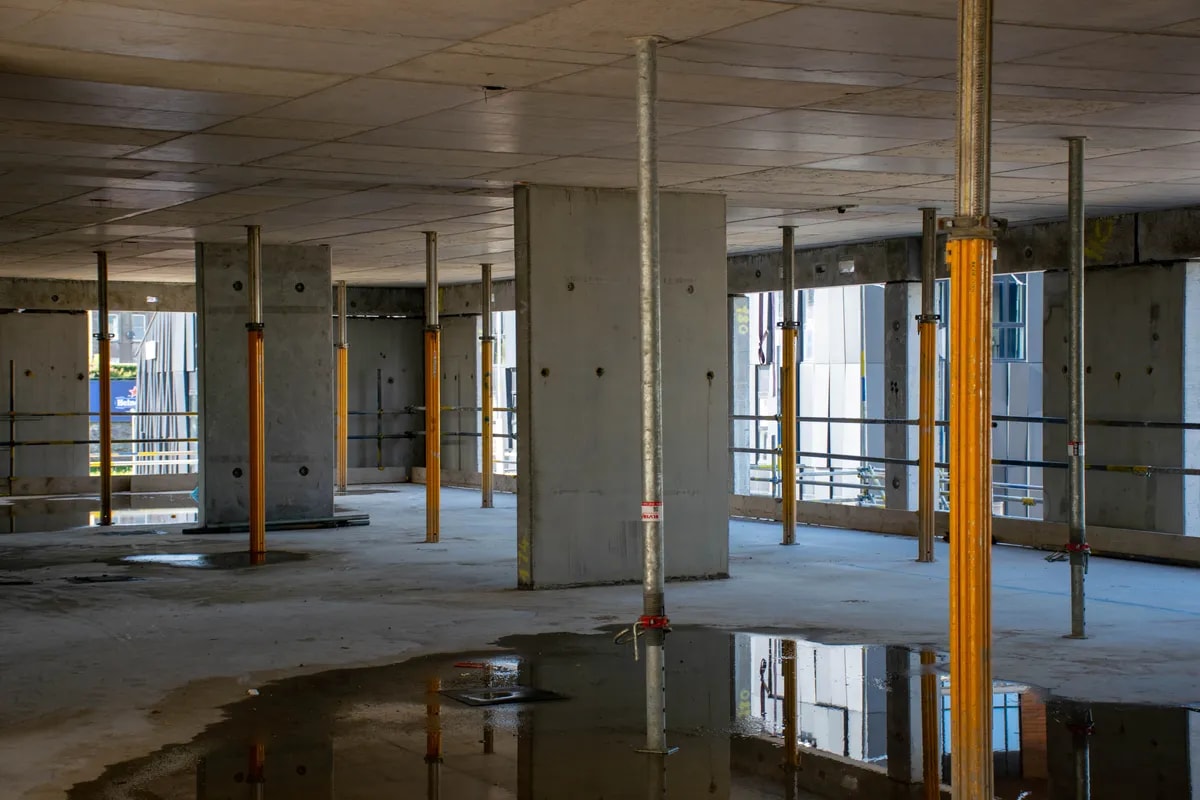

Propping and back-propping

Props under new slabs and through the floors below them, sized against the strength the concrete has on the day it is loaded, with the striking sequence set out.

Openings in existing walls

Needles, props and temporary beams for a wall being opened up, designed together with the permanent beam that takes over from them.

Excavation support

Trench and basement shoring, sheet piles and underpinning sequences, designed from the ground information rather than from a guess at it.

Formwork and falsework

Wall and column shutters checked for concrete pressure and rate of rise, and falsework designed to .

Crane bases and outrigger pads

Tower crane foundations and the pads under mobile crane outriggers, checked against the bearing the ground or the slab can actually give.

Working platforms and piling mats

Granular platforms for piling rigs and cranes, designed for the track loads the plant on site applies.

Facade retention

Steelwork that holds a retained front up while the building behind it comes down and goes back up, staged with the demolition.

Hoarding and scaffold

Hoarding designed for wind, on kentledge or foundations, and scaffold designed wherever the arrangement falls outside the standard solutions.

Temporary bridges and access

Gantries, access structures and temporary crossings that carry plant and people over a gap the permanent works have not closed yet.

Precast erection stability

The propping and the lift sequence that keep a precast frame stable until its connections are made and its floors act together.

Design check categories

-1:2024 sets how independent the check of a temporary works design must be by how complex the design is. In Ireland it is a code of practice rather than law, and it is what most main contractors' procedures ask for.

Who checks the design
  1. Category 0

    Another member of the site or design team

  2. Category 1

    Another member of the same design team

  3. Category 2

    An engineer who had no part in the design

    We check and sign

  4. Category 3

    A separate organisation

    We check and sign

Each category asks for a check more independent than the one before it. The category follows how complex the design is and what happens if it is wrong.

CategoryDesignWhat it means
Category 0Standard solutionsA published or proprietary solution used inside its stated limits. Checked by another member of the site or design team.
Category 1Simple designsA straightforward design with little that can go wrong. Checked by another member of the same design team.
Category 2We check and signMore complex designsChecked by an engineer who was not involved in the design and was not consulted by the designer.
Category 3We check and signComplex or innovative designsUnusual methods, high consequences or designs at the edge of the guidance. Checked by a separate organisation.

What you receive

Every design is issued as a set the site can build from and the safety file can keep.

  • Calculations and drawings, issued for construction
  • The loading limits on the permanent works at each stage
  • The erection, loading and striking sequence, on the drawing
  • The criteria for the permit to load and the permit to strike
  • An independent check at Category 2 or 3, where the job needs one
  • The certificate, and the information the and the need from a designer
