SuDS and Drainage Design

Surface water, foul drainage and watermains designed to council SuDS policy and Uisce Éireann standards.

Every new building has to deal with the rain that lands on it. Councils now expect most of it to be held, cleaned and soaked away on the site, with pipes and tanks as the last resort rather than the first.

Kildare's development plan requires SuDS on all new development, down to a single house, and the Dublin councils ask the same through their own guides. A design is judged on three things: how much rain is held, how fast the rest is let go, and who maintains it.

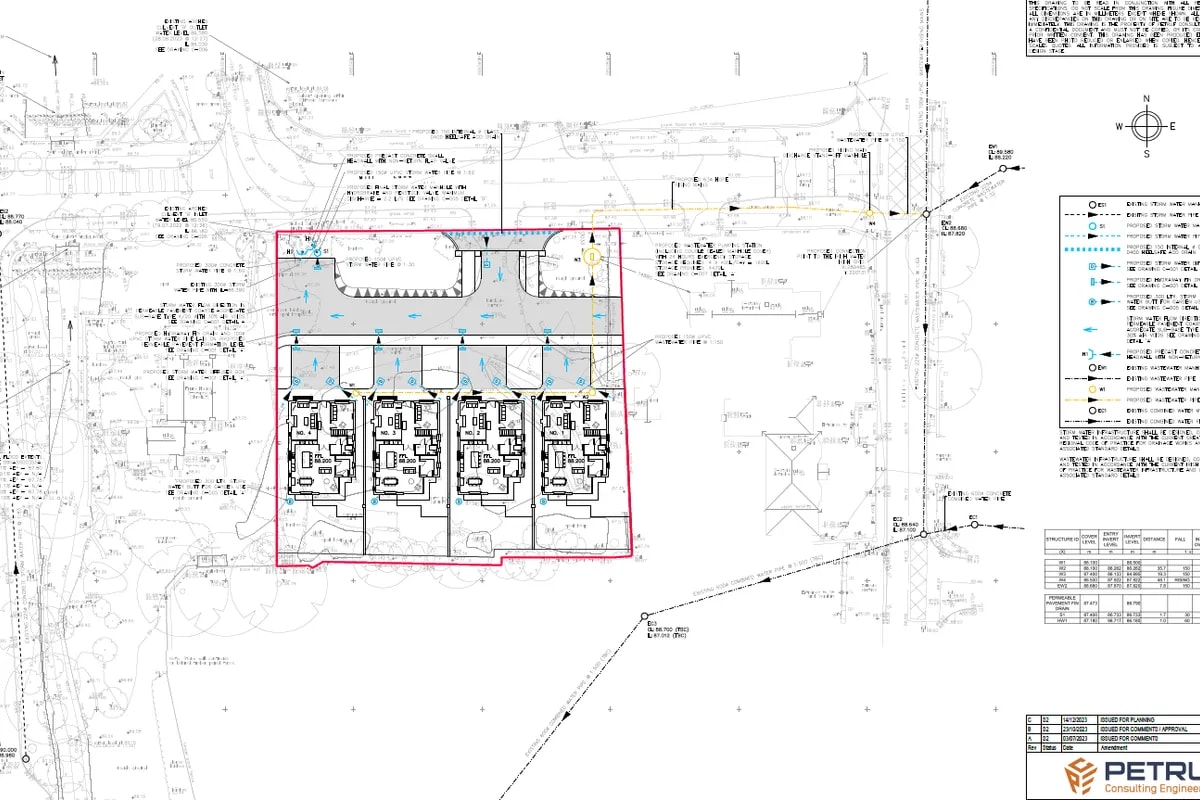

We design the surface water, the foul drainage and the watermain on the same drawings as the levels and the foundations, carry out the soakaway tests on the site, and run the Uisce Éireann applications from the pre connection enquiry to the network being taken in charge.

What we design

SuDS measures

Swales, rain gardens, filter drains, tree pits and green roofs, chosen for the site and sized for the storms it has to take.

Permeable paving

Driveways, parking and footpaths that store rain in their own build up and let it through.

Soakaways and infiltration

Infiltration tests carried out on the site to , and soakaways sized from the rate the ground actually gives.

Attenuation and flow control

Storage and a flow control that hold the discharge to the greenfield rate, where infiltration alone cannot.

Surface water networks

Pipes, manholes and outfalls with falls that work against the finished levels.

Foul drainage

Wastewater networks kept separate from surface water, to the Uisce Éireann Code of Practice and standard details.

Pumping stations

Foul and surface water pumping stations where the site cannot drain by gravity.

Watermains

Water supply layouts with the valves and connections Uisce Éireann will take over.

Uisce Éireann applications

Pre connection enquiries, confirmation of feasibility, design submissions and connection applications.

Taking in charge

Drawings and submissions for the council and Uisce Éireann to take the drains, the mains and the roads over.

What the council will check

These are the figures a surface water design is held to across most of Ireland. Each council sets its own, and they are agreed with its drainage section before the design is fixed.

Quick site numbers

Interception storage at 5 mm

15 m³

At 10 mm, the preferred figure
30 m³
Least practical discharge, at 2 l/s/ha
1 l/s

A first look, not a design. The rate the council allows is the site's greenfield runoff, from , and 2 is commonly taken as the least a flow control can practically hold. The attenuation volume depends on the site's own rainfall figures and the climate change allowance, and is worked out in the design.

CriterionTypical requirementWhere it comes from
InterceptionThe first 5 mm of rainfall held on the site, 10 mm preferred, so it never reaches a drainThe Greater Dublin Regional Code of Practice for Drainage Works, applied well beyond Dublin.
Discharge rateNo faster than the greenfield runoff rate, QBAR from IH124, with 2 l/s/ha as a practical minimumThe , and council development plans.
Climate change10% added to rainfall in the GDSDS; most councils now ask for 20%, some 30%Agreed with the council's drainage section for each site.
InfiltrationSoakaways sized from an infiltration test on the site, required by planning condition.
Attenuation tanksA last resort, where surface and nature based measures cannot do the jobKildare and South Dublin SuDS guidance.

What you receive

Drawn to what the authority will take in charge, not to what fits the site plan.

  • A SuDS strategy, and the surface water report the planning application needs
  • Infiltration test results and the soakaway design
  • Drainage layouts and long sections for surface water and foul
  • Attenuation and flow control calculations, with the climate change allowance shown
  • The watermain layout
  • The Uisce Éireann pre connection enquiry and design submission
  • A maintenance plan for the SuDS, and the response to any further information request
